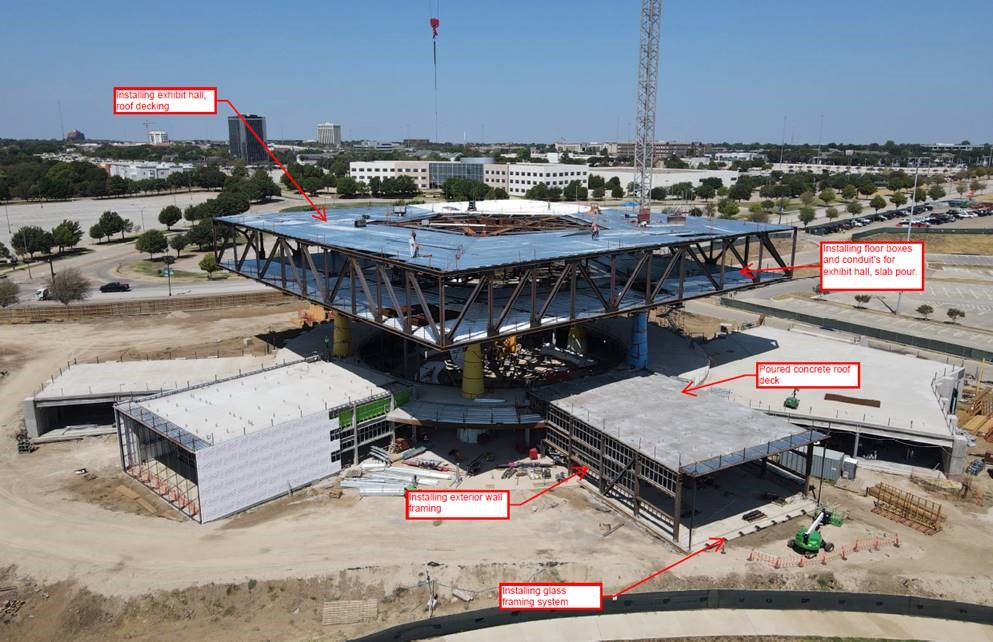

Overview/Project Accomplishments:
- Pour Concrete roof deck on Great Hall.
- Installing Exhibit Hall Roof Decking.
- Installing Electrical Floor Boxes & conduit on Exhibit Hall floor.
- Installing Spiral Stairs (Ongoing).
- Installing CMU around pump house.
- Installing Great Hall glass framing system.
- Interior Rotunda level Wall Framing (Ongoing).
- Installing Overhead MEPF conduits, duct & pipe throughout the Rotunda.

Exhibition Hall Concrete Pour
Get ready for more concrete!
Approximately 500 yards of concrete will be poured at the Exhibition Hall floor on 11 September with a second pour tentatively scheduled on 15 September.

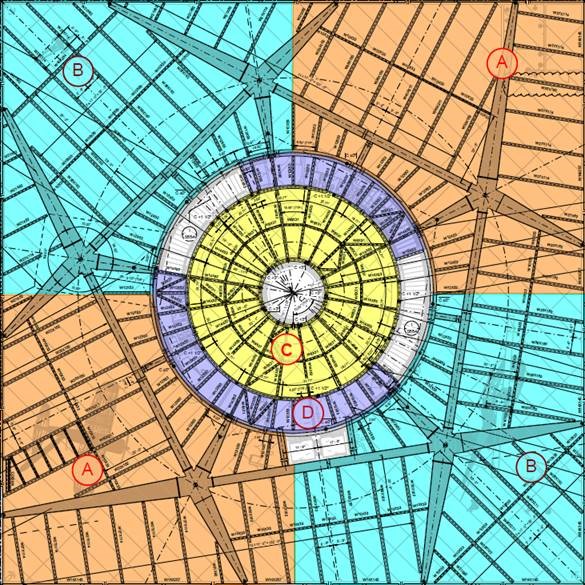

Due to the way the structure is designed to move during construction (structure sequencing), the North-East and South-West quarters will be poured first (in orange, Area ‘A’). Our teammates from Linbeck are self-performing the work.

Exhibition Hall Concrete Pour Sequence

If you would like to view a time lapse picture of the site, please use the link below:
