Progress Update #45

Date

Museum Construction Site Weekly Progress Update #45

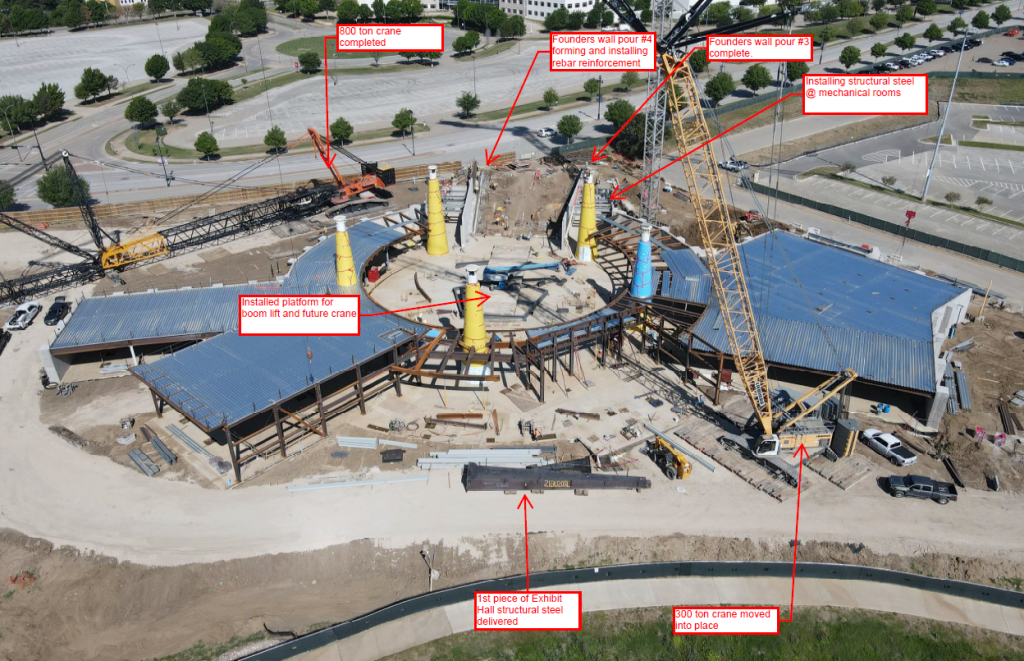

Overview/Project Accomplishments:

  • Founders wall pour #3 completed.
  • Founders wall pour #4 forming and placing reinforcement.
  • Installed structural platform in the Rotunda area for equipment and future crane placement.
  • The 300-Ton Crane moved into position on the East side of the building.
  • The 800-Ton Crane (‘THE BEAST’) erection completed and moved into position.

EXHIBIT HALL STRUCTURAL STEEL PLACEMENT

The 1st piece of Exhibit Hall structural steel has been delivered to the site, this piece will attach and cantilever off Mega-Column #5 (NAVY) Super Node.  See the model below showing where this piece will be placed in the Exhibit Hall.

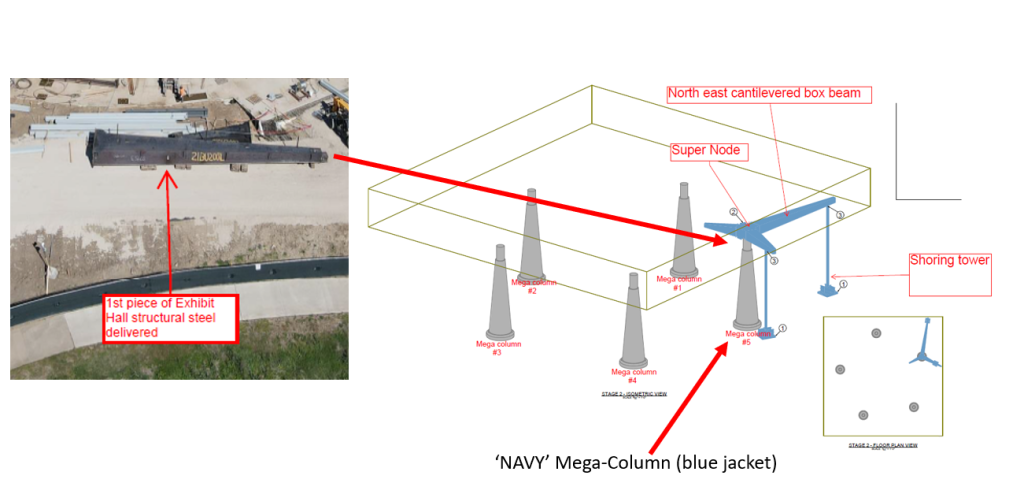

Picture 2:   Exhibit Hall Structural Steel Placement
Exhibit Hall Structural Steel Placement

If you would like to view a time lapse picture of the site, please use the link below:

https://oxblue.com/pro/slideshow/nationalmedalofhonormuseum/mostrecent
